Kalāwahine 24-Inch Water Main Project

Project Overview

  • FV Coluccion Construction Company, Inc, the Board of Water Supply’s (BWS) contractor for the Kalāwahine 24-inch Water Main project is working to install approximately 4,900 feet of new 24-inch water mains along the following areas:

    • Pensacola Street from Kinau Street to Nehoa Street

    • Auwaiolimu Street from Nehoa Street to Anianiku Street

    • Anianiku Street from Auwaiolimu Street to Fire Hydrant M02678

  • Current work schedule:

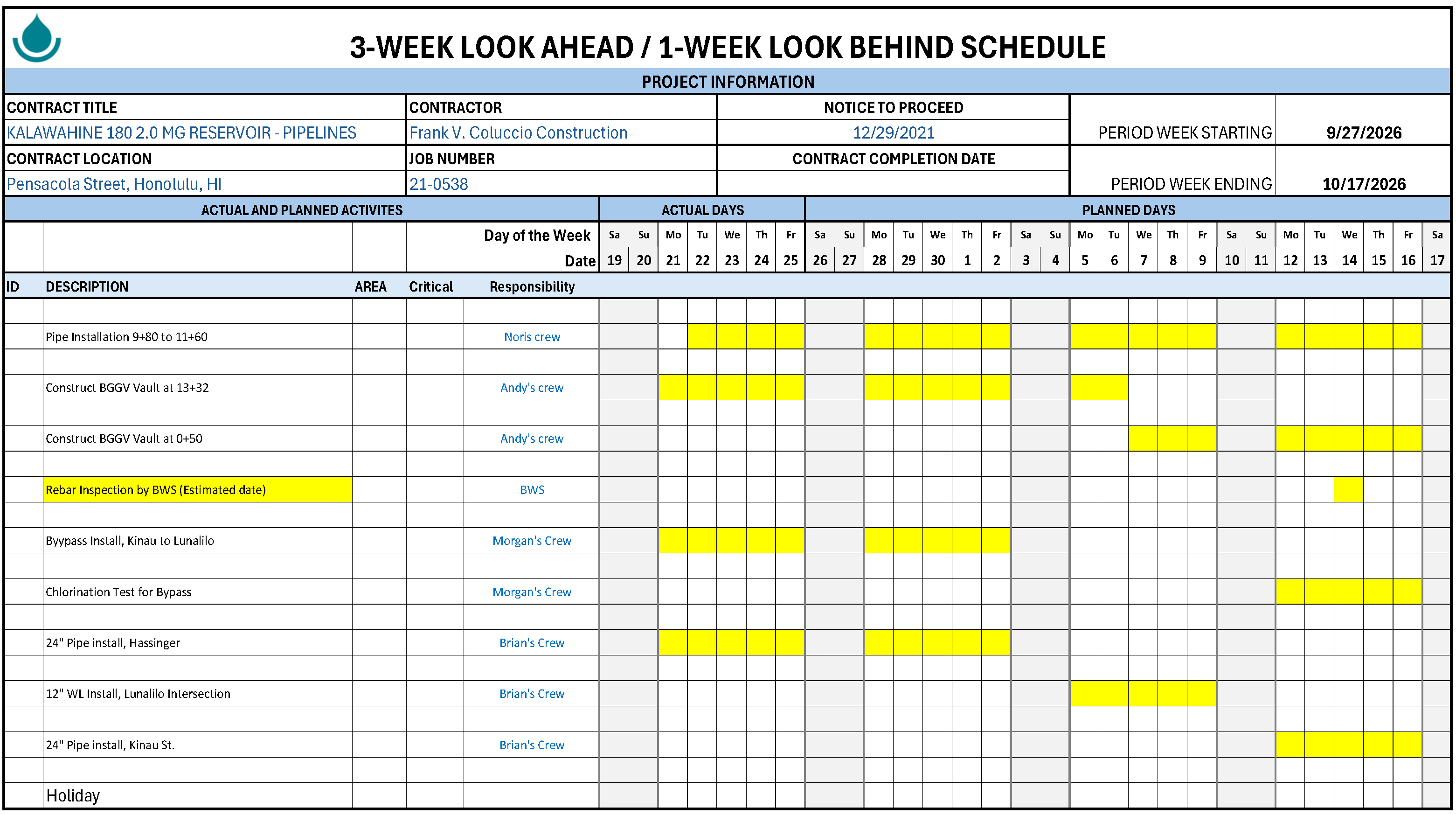

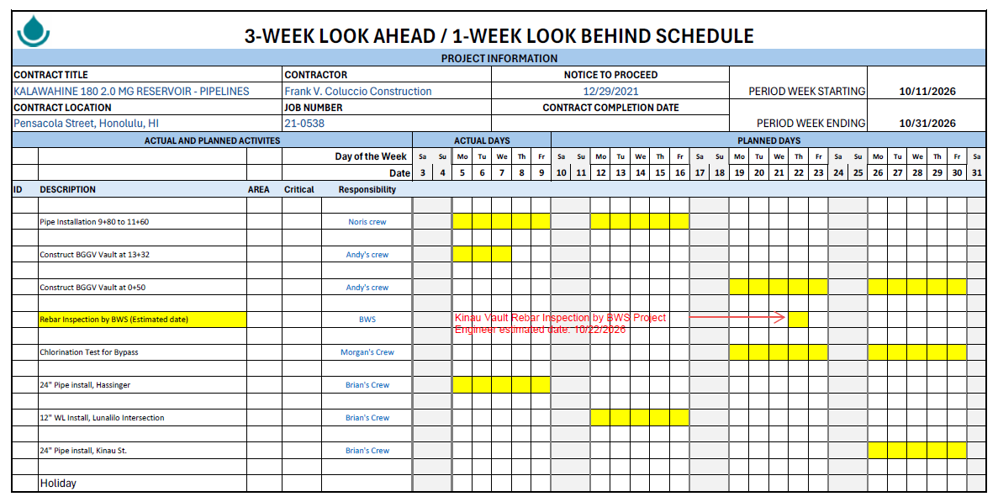

    3 Week Schedule 11.22.26 12.12.26

  • The construction of this 24-inch water main is a necessary to create water system redundancy, improve performance and reliability. It will also assist in meeting domestic fire protection needs.

  • Weather permitting working hours are Monday to Friday, from 8:30 a.m. to 3:30 p.m., except for observed state holidays.

  • Questions or concerns: Call the BWS at (808) 748-5041 or email contactus@hbws.org.

This project will involve traffic modifications and lane closures along the work site. When the project begins road users are advised to obey all traffic controls, posted signs, and special duty officers.

Disclaimer: This website provides current project information as it becomes available. Please note that there may be times where lane closures could change without notice.

Overall Project Schedule (as of 11/20/2026)

Overall Kalawahine Project Schedule (as of 05/05/2026)
